Changing Your Mind Mid-Renovation: How Variation Orders Actually Get Priced
The tiles are down, the carpentry is in, and you walk into the flat on a Saturday and realise the bathroom would be better if the shower were on the other wall. Or the kitchen island wants to be 200mm longer. Or you have seen a tap you like more than the one you picked.
That change has a name in the trade. It is a variation, and it is the single most common reason a renovation ends up costing more than the quotation everyone signed at the start. Not dishonest contractors, not hidden charges — decisions made after work has begun.
Variations are not something to avoid entirely. Some are worth every dollar. But the ones that hurt are the ones people do not realise are variations until the bill arrives, so here is how they actually get priced, and what to settle before you sign anything.
What a variation actually is
A renovation quotation prices a defined scope: these walls hacked, this area tiled, this much carpentry, these points moved. Anything that changes that scope after it is agreed is a variation — an addition, a deletion, or a substitution.
Substitutions catch people out most. Swapping one tile for another sounds cost-neutral, and if the two tiles cost the same it nearly is. But if the new tile is a different size, the setting-out changes, the cutting changes and the labour is not the same job. The material was never the expensive part.
Why the same change costs more mid-job than it would have at the start
This is the part that feels unfair from the outside, and it is worth understanding because it is genuinely not a mark-up on your indecision.
A renovation is a sequence. Wet works before finishes, first-fix electrical before plastering, carpentry after floors. Every trade is booked into a slot, and the slots are stacked back to back because that is what keeps a renovation to eight or ten weeks rather than five months.
When a change lands after a trade has finished, three costs appear at once. The work already done has to be undone, which is labour spent twice with nothing to show. The trade has to be brought back, which is rarely the next day because they are on another job. And the trades booked behind them either wait or get moved, which is where a small change quietly becomes a schedule problem. We wrote separately about what to do when a renovation runs late, and mid-job variations are one of the two or three usual causes.

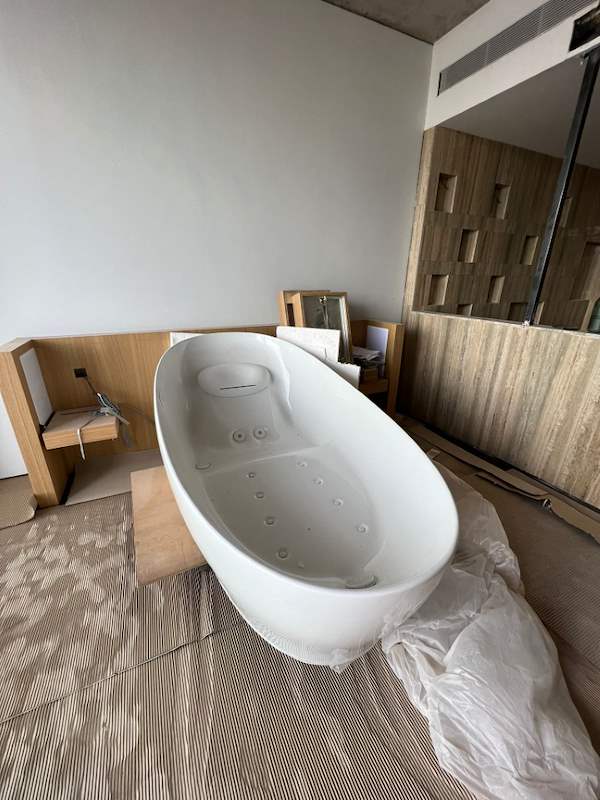

The photograph on this post is a condo bathroom part-way through: the tub is in position, the floor is protected, the feature wall is up, and the room is not finished. That is exactly the moment when a change is still cheap — and the moment after it, when the tub is plumbed and the floor is grouted, is when the same change stops being cheap.
The five changes that cost the most
1. Anything that touches waterproofing
Moving a floor trap, a shower position or a bathroom wall means the waterproofing membrane is breached. That is not a patch. It is a re-do of the affected area, another screed, and — critically — another curing and water test before tiling can start. The material is minor; the time is not. Our note on why bathroom waterproofing matters explains why nobody sensible rushes that step.
2. Anything that moves a service
Relocating a power point, a light, a water point or a waste connection after the walls are closed means opening them again, then making good, then repainting the affected wall — which rarely stops at the patch, because a repainted section of wall does not match a wall painted three weeks earlier.
3. Anything already fabricated
Carpentry is made to a drawing, off site, at a fixed size. Once a run of cabinetry is cut, a change of dimension is a new piece, not an adjustment. This is why the carpentry drawing sign-off is the single most important signature in a renovation, and why a good contractor will push you to walk the drawing rather than glance at it.
4. Anything that needs a fresh permit
In an HDB flat, hacking and several other works require an approved renovation permit, and the permit describes the works. A change that goes beyond it is not simply a pricing question — it has to be applied for, and the works cannot proceed in the meantime. Our HDB renovation permit guide covers what falls inside and outside a permit.
5. Anything that idles other trades
The most expensive variations are often small in themselves. A three-day pause at the wrong point in the sequence can push the tiler, the carpenter and the painter each into their next commitment, and the flat sits untouched while everyone waits for the next available slot.
How a fair variation is priced
A variation should be quoted the same way the original job was: labour, materials, and the knock-on. Specifically, you should be told three things before the change is carried out — what it adds or removes in cost, what it does to the completion date, and what has to be undone to make it possible.
If a change is presented as a single number with no breakdown and no date impact, ask for those two missing pieces. Not because the number is wrong, but because the date is the part that costs you money elsewhere — a delayed move-in, an extended rental, a tenancy that starts late.
The deletions matter too. If you remove something from the scope, that should come off, and it should come off at the rate it was priced at. A variation account runs in both directions.
What to settle before you sign
Four things, and they cost nothing to ask for:
- How variations will be priced and communicated. In writing, before work, with a cost and a date impact. Agree that no variation proceeds without your written go-ahead.
- A dated schedule of decisions. Ask your contractor for the last responsible date for each choice — tiles, sanitary ware, carpentry laminates, paint colours, tap finishes. A decision made before its date is free. The same decision a week later is a variation.
- What is provisional in the quotation. Some items are honestly quoted as allowances because the real cost depends on a selection you have not made. Know which lines those are, so a later adjustment is not a surprise.
- Who signs off the carpentry drawings, and when. Put a date on it and treat it as a hard gate.
The variations that are usually worth it
Not every change is regret. Three that generally repay themselves: fixing something the demolition uncovered, such as concealed seepage or aged pipework, because it will not get cheaper later; adding electrical points while the walls are open, because the marginal cost then is a fraction of the cost afterwards; and upgrading anything genuinely difficult to change later, such as flooring or waterproofing, over anything easy to change later, such as a light fitting or a tap.
The mirror image is also true. Changes to finishes you can swap out in an afternoon — handles, taps, pendant lights — are the ones to resist mid-job, because they can be done cheaply once you have moved in and the trades have gone.
The honest summary
Most renovation overruns are not surprises, they are decisions. The quotation is only as fixed as the scope behind it, and the scope is only as fixed as the decisions you have actually made. The contractors who end up in disputes are frequently the ones who never wrote down what a change would cost before doing it — and the homeowners who end up angry are frequently the ones who never asked.
We work as a direct contractor rather than through a middleman, which means the person pricing your variation is the person doing the work, and the reason for the number is available to you rather than filtered through a third party. Our HDB licence number is HB-09-5667H, and it is worth checking that number for any contractor you are considering, not only us — see what an HDB licensed renovation contractor is allowed to do.
